A failing software project doesn’t just collapse dramatically. It fails due to unclear requirements, missed sprint commitments, weak release discipline, vague vendor updates, recurring defects, and a codebase.
And by the time the leadership team says, “We’re in a crisis, and we need a custom software project rescue to fix it,” the problem doesn’t just remain restricted to bad code but extends to a loss of technical control.
Then, what’s the solution? Introducing custom software project recovery.
Having a proper recovery effort is not just about adding more developers or blindly rewriting modules. It begins with a structured 30-day post-mortem that examines architecture, code quality, backlog health, CI/CD maturity, QA coverage, vendor dependency, infrastructure access, and delivery governance.
For C-suite executives and product leaders, the achievement isn’t about cosmetic repair. Their primary goal is to understand whether the product should be stabilized, rebuilt, revamped, replaced, or discarded.
According to a RAND Corporation study, 80% of AI projects fail, which is twice the failure rate of non-AI IT projects. Even for traditional software projects, McKinsey research shows 70% of large-scale IT projects fail to achieve their intended business value. Besides, the Standish Group CHAOS Report states that 19% of projects are canceled, 50% exceed deadlines and budgets, and 31% are entirely successful.
Software project failures mostly happen because delivery risk compounds way faster than leadership can notice. A missed deadline becomes a revised roadmap, which turns into scope pressure, leading to shortcuts and increased technical debt.
Now, technical debt slows delivery. And in the end, the team is seen spending more time managing instability rather than building product value.

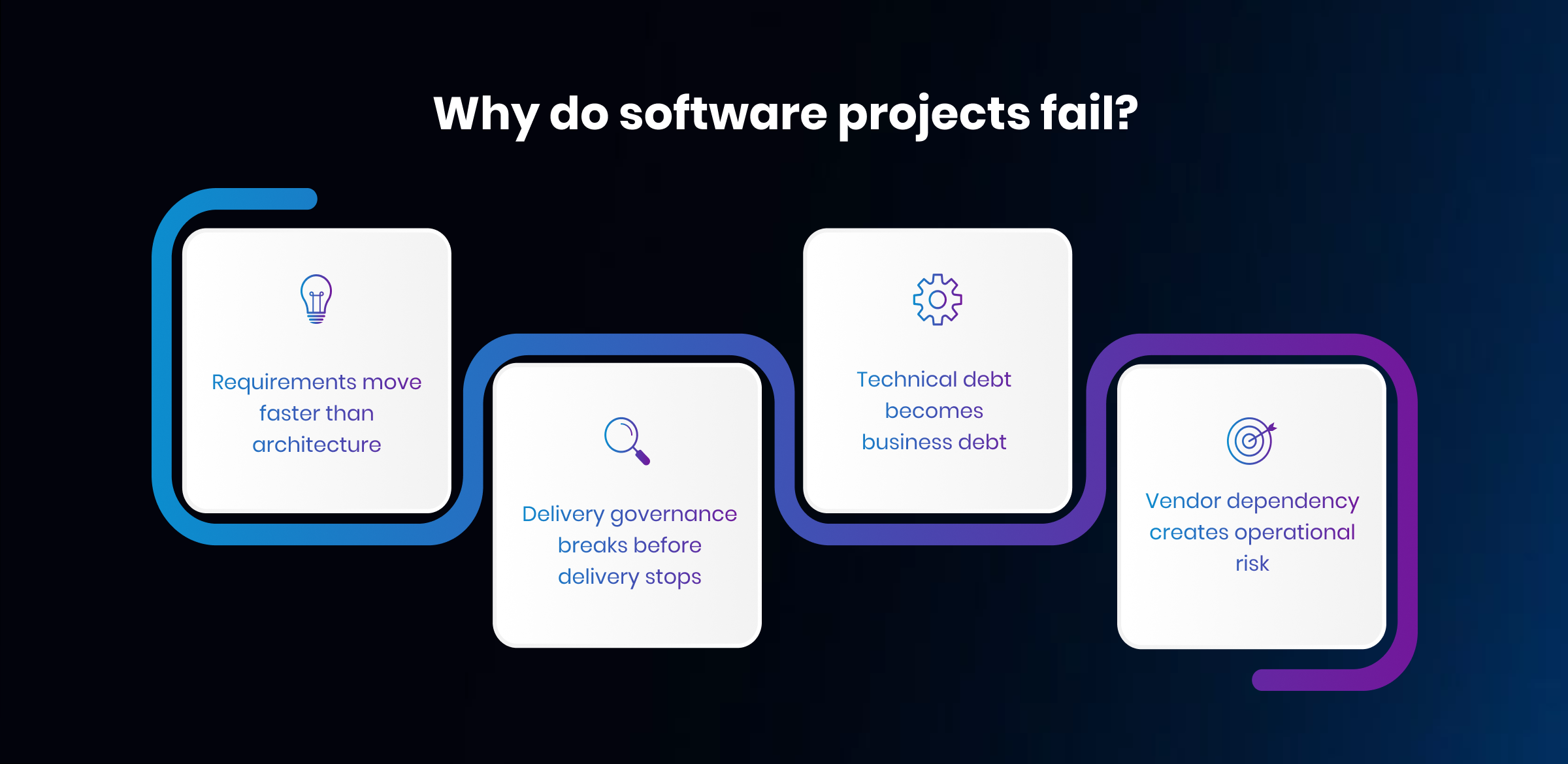

Here are some reasons why software projects face failures –
One of the biggest reasons for software project failure is uncontrolled changes to requirements. Custom software is expected to evolve; however, evolution without architectural discipline leads to chaos.
When needs and goals change without impact analysis, teams start adding patch logic, duplicate workflows, temporary integrations, and unstable workarounds. This results in architectural debt, poor maintainability, and a growing blast radius around every change.
This is why custom software development services require impactful technical governance. It’s well known that custom software gives businesses flexibility; nevertheless, flexibility without architectural control poses a long-term risk.
Most projects look active even when they’re failing. Every process moves smoothly:
But none of that defines delivery health. The main issue here is broken product delivery governance.
If your development cycle lacks a release owner, an architecture decision log, reliable sprint planning, a clean backlog, or a clear escalation process, offshore development risks often show up.
Every product has technical debt, which isn’t the main issue; the primary challenge here is unmanaged debt.
This happens when teams avoid certain modules, and as changes trigger regressions, the product roadmap becomes a hostage to the codebase.
This is when a technical debt audit becomes a business necessity:
It helps leadership teams identify which parts of the system are tolerable debt, require refactoring, and should be rebuilt.
Having a bad software development partner not only causes delivery delays but also creates operational dependencies. If the vendor you choose controls repository access, infrastructure, deployment scripts, secrets, environments, documentation, or release processes, the business loses complete control over its own product. This is what leads to the real cost of vendor lock-in in software development.
A software project takeover begins with asking one question:
Can another engineering team understand, deploy, and maintain this system without the interference of the current vendor?
If your answer is no, the issue isn’t just a delay; it’s something bigger than that; it’s a control failure.
A struggling software project rarely fixes itself. Every month spent delaying intervention increases technical debt, extends time-to-market, and raises recovery costs. Missed deadlines can quickly turn into lost revenue opportunities, customer dissatisfaction, compliance risks, and reduced stakeholder confidence.
The earlier organizations identify delivery risks and initiate recovery, the more options they have to stabilize the project without a complete rebuild.
Before we discuss this, let’s first understand:
Software projects fail due to unclear requirements, weak governance, technical debt, poor CI/CD practices, low test coverage, broken workflows, misaligned stakeholder expectations, and lack of reliable metrics to guide safe, repeatable delivery.
A 30-day post-mortem replaces assumptions with data-driven insights. It detects what is broken, what is recoverable, what needs rebuilding, and what process should stop immediately. This is said to be the foundation of a custom software project rescue.
The need for software project rescue services becomes important when the warning signs are prominent and no longer isolated incidents.
Common signs of a bad software vendor include:
These aren’t just red flags but signs that the project needs an initial project assessment before making an investment.
Software project recovery services are well-defined interventions that are used to stabilize a dysfunctional software product. Software project recovery is an umbrella service that includes:
To ensure a strong recovery engagement, first answer these questions:
This is where recovery overlaps with application modernization services and legacy software modernization. If your product is outdated, brittle, poorly documented, or difficult to deploy, modernization might be an integral part of recovery.
But it’s important to remember that modernization must be selective, where the objective shouldn’t be to rewrite everything but to restore maintainability, security, delivery speed, and business confidence.
Software project recovery typically takes 1 week to 6 months, depending on project size, complexity, technical debt, team readiness, and severity of delivery issues. Structured triage, CI/CD stabilization, and prioritized backlog execution accelerate recovery.
When a software development partner fails to deliver on what’s promised, the first step isn’t confrontation; it’s collecting data.
The most important steps for the leadership are to freeze uncontrolled scope changes, secure system access, gather delivery artifacts, and establish temporary recovery governance. Doing so prevents further drift while the technical team performs software project due diligence.
The steps should include access to repositories, cloud environments, deployment pipelines, credentials, logs, backlog history, test reports, sprint reports, and architecture documents. Without this, any software development rescue plan will just become guesswork.
A software development partner audit should evaluate both technical output and delivery behavior. Although code quality is important, it’s not enough. A vendor can have the expertise to produce acceptable code but fail due to weak governance, poor communication, poor documentation, fragile deployment processes, and unclear ownership.
A proper audit covers architecture, code quality, QA maturity, DevOps process, security posture, backlog health, documentation quality, communication cadence, and access control.
Also, from a technical standpoint, auditing should include dependency mapping, dependency graph analysis, SAST and DAST checks, hardcoded secrets detection, environment parity review, database migration review, API contract validation, and observability maturity.
Tools such as GitHub Actions, Snyk, Terraform, Sentry, and Datadog can further help reveal whether your product has a stable engineering backbone or a fragile delivery surface.
When Should a Project Be Retired?
Not every project should be rescued. In some cases, the most strategic decision is to stop further investment and redirect resources elsewhere. Consider retiring a project when:
Product-market fit no longer exists.
A structured assessment helps leaders distinguish between projects that need recovery and those that need closure.
The first week of urgent software project recovery focuses on control. The best is to freeze scope except for critical defects, security issues, compliance risks, or business continuity blockers.
The recovery team should secure access to the repo, infrastructure, CI/CD, environments, backlog exports, incident history, and documentation. After securing access, the team creates a failure map across product, architecture, engineering, delivery, and vendor dependencies.
The goal here isn’t to fix everything in week one, but to understand the failure system. A slow or delayed release is caused by weak QA, poor CI/CD, unstable environments, vague acceptance criteria, or tightly coupled architecture. The post-mortem strategy must identify the true cause before initiating treatment.
The second week deals with the technical core. During this phase, teams perform a software architecture review, address technical debt, a software quality assurance audit, and a DevOps audit.
Audits can now leverage AI-powered tools, such as Copilot or Sourcegraph Cody for code review, Diffblue and CodiumAI for automated test generation, and Dynatrace or New Relic AI for observability, to accelerate detection of risky code patterns, coverage gaps, and performance anomalies.
This includes reviewing modularity, database design, API boundaries, authentication and authorization, third-party integrations, test coverage, deployment pipelines, security controls, rollback strategy, and the observability stack.
The output should be a stabilization priority matrix:
This generates the base for recovery planning and roadmap development.
The third week focuses on delivery stabilization and execution. At this stage, the recovery team tries to make the delivery safe again.
This is where CI/CD implementation becomes crucial. A recovery team should build a CI/CD baseline, add automated checks, improve test coverage around critical workflows, define release ownership, create rollback procedures, and strengthen monitoring.
To measure progress, it’s important to track the official DORA (DevOps Research and Assessment) metrics:
These metrics indicate whether the project is becoming governable again. Without this discipline, feature velocity can be misleading.
The question here is whether teams can release safely, repeatedly, and reliably.
| Metric | Low | Medium | High | Elite |
| Deployment Frequency | Monthly or less | Weekly | Multiple times per week | Multiple deploys per day |
| Lead Time for Changes | 1–6 months | 1–4 weeks | 1–7 days | <1 day |
| Change Failure Rate | >30% | 16–30% | 8–15% | 0–7% |
| Time to Restore Service | >1 week | 1–7 days | <1 day | <1 hour |
| Operational Reliability (Availability / SLO compliance) | <95% | 95–98% | 98–99% | 99–100% |

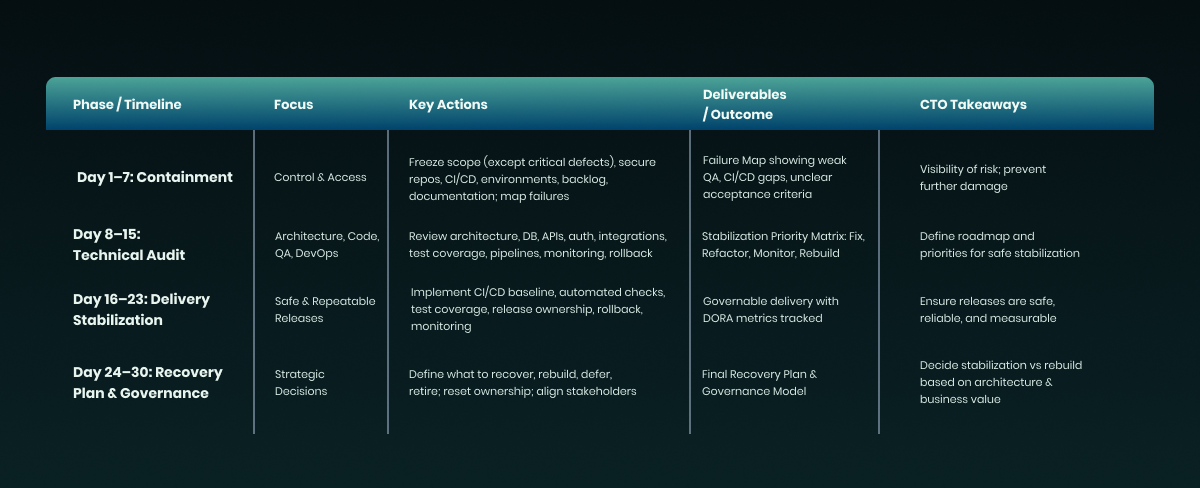

The fourth and final week should focus on building the actual software project recovery plan. Here, define what will be recovered, rebuilt, deferred, and retired, as well as what challenges remain. It should also establish ownership across architecture, product, release, QA, DevOps, and stakeholder communication.
Project stabilization occurs when the business goal remains valid, the architecture is recoverable, and stabilization can create value faster than a rebuild.
But when should you rebuild?
Rebuilding is crucial when the core architecture is structurally unsound. Rebuild when a platform or vendor dependency creates unacceptable risk, and stop when business value no longer justifies investment.
A strategic software project rescue partner should be experienced enough to guide through any of these paths.
At a glance:
How does recovery become a successful project rescue?
A 30-day post-mortem is the point at which recovery becomes feasible, where businesses have evidence, priorities, owners, and a roadmap.
Consider a logistics platform that experienced repeated release failures, poor documentation, and vendor-controlled infrastructure after more than a year of development. A structured recovery assessment revealed that the architecture was recoverable, but delivery governance was not.
By stabilizing CI/CD, documenting critical workflows, restoring infrastructure access, and resetting ownership, the organization avoided a costly rebuild and resumed predictable releases within months.
Stabilization has no universal timeline, but usually begins within the first 30 days. Based on Unified Infotech’s recovery engagements, full stabilization typically requires 60 to 90 days, or longer, depending on the codebase condition, infrastructure maturity, vendor cooperation, documentation quality, release complexity, and business urgency.
Choosing an MVP rescue stabilizes faster because the scope is narrower. An enterprise system with hardcoded secrets, poor test coverage, weak deployment controls, missing documentation, and vendor-controlled infrastructure takes longer to implement.
Blindly promising speed is something that you should avoid. The goal here is to create a realistic, audit-backed recovery path.
Technical debt affects recovery by raising uncertainty. In a healthy software project recovery system, teams can negate a defect, alter a module, test the change, and deploy safely. In a debt-heavy system, every change feels risky because dependencies are often unclear and the risk of regression is high.
A good recovery team doesn’t consider all debt to be equal. They evaluate blast radius, business impact, release risk, and roadmap dependency. That’s how software project recovery strategies become realistic instead of cosmetic.
CI/CD is one of the strongest indicators of recovery potential. A team without CI/CD may continue to write code, but cannot reliably build releasable software. A healthy recovery effort includes automated builds, automated tests, static analysis, dependency checks, deployment gates, environment consistency, and rollback capability.
CI/CD is known to improve risk mitigation in software engineering by detecting failures in the initial phases and reducing release uncertainty. This gives leadership teams visibility into whether delivery is improving through measurable signals, rather than optimistic reports.
Engineering team augmentation should not come before diagnosis. Deploying engineers to a broken system increases coordination overhead and builds chaos.
Once the post-mortem identifies capability gaps, augmentation can be considered. The business may need a solution architect, a DevOps engineer, a QA automation lead, a frontend engineer, a backend engineer, a cloud specialist, or a delivery manager.
Recovery does not end when the platform becomes stable. To prevent recurrence, organizations should establish a governance model that includes architecture reviews, security assessments, release readiness checks, backlog audits, and DORA metric tracking. For regulated industries, governance should also include compliance reviews aligned with requirements such as GDPR, HIPAA, SOC 2, or industry-specific standards.
Strong stakeholder communication is equally important. Leadership, engineering teams, vendors, and business stakeholders should operate from a shared view of risks, priorities, delivery progress, and recovery milestones. Transparency restores confidence faster than optimistic reporting.
What makes a successful recovery?
A successful project stabilization is measured not only by launch but also by the restoration of control.
It produces working software, stable releases, clear ownership, improved test coverage, stronger CI/CD, reduced vendor dependency, clean documentation, transparent reporting, and a practical handoff or support model.
The strongest outcome is building a system in which the same failure pattern is less likely to recur.
Not every vendor performs equally. While some offer quick fixes, others will provide more developers or recommend a rebuild without proof. But none of those is enough. Here are some steps that you should consider when finding the right vendor –
A strong software project recovery partner should begin with information. They should ask for repository access, architecture documents, backlog history, deployment logs, incident reports, test reports, cloud details, and vendor dependency information.
They should not promise a fixed recovery timeline before reviewing the system. They should not recommend a rebuild without assessing salvageability. They should not confuse confidence with proof.
A serious project rescue partner needs more than developers. Recovery requires architectural judgment, QA maturity, DevOps discipline, product thinking, security awareness, and executive communication.
The team should be able to perform code audits, software architecture reviews, technical debt audits, software quality assurance audits, and DevOps audits. They should understand how risks in software development affect cost, timeline, security, customer experience, and business continuity.
Any recovery assessment must include ownership.
Ask these questions:

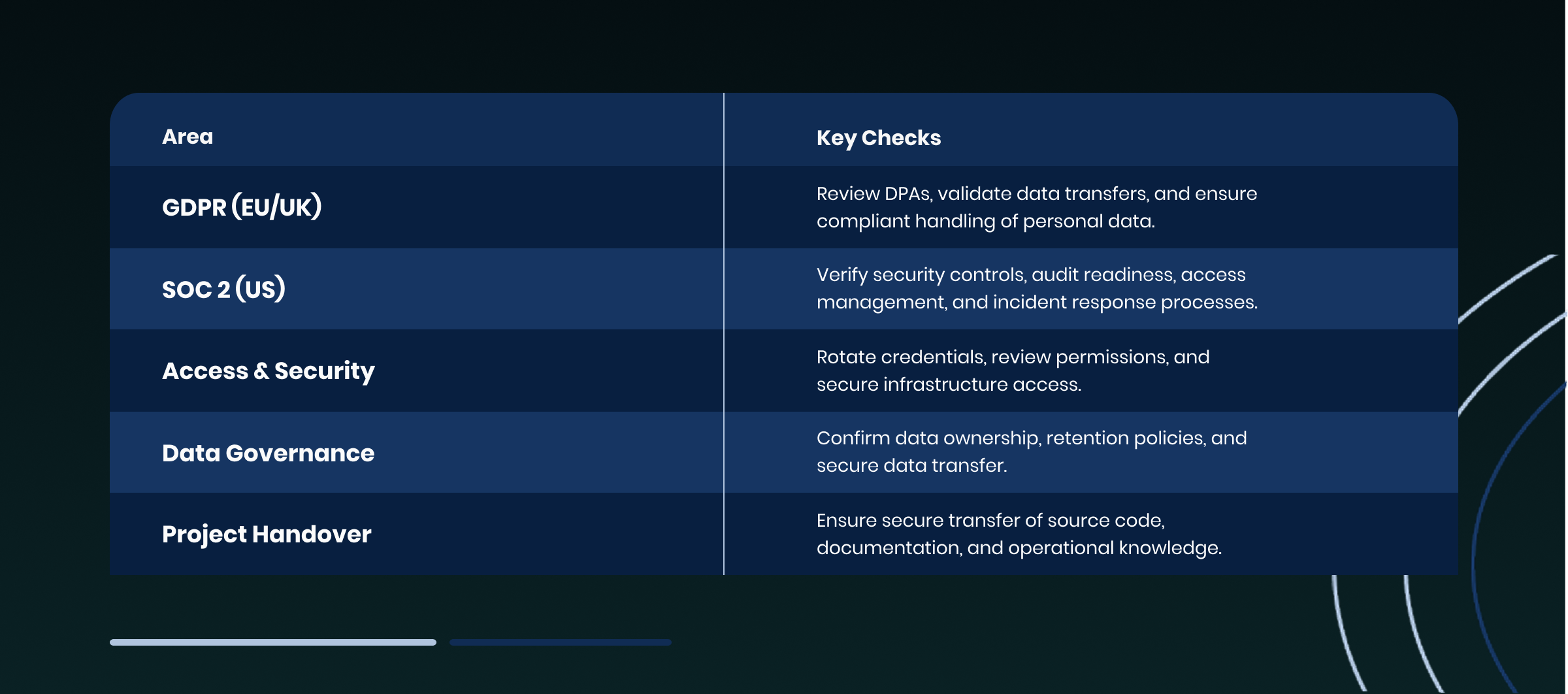

If those answers are unclear, vendor lock-in in software development is already affecting recovery.
A strong partner will create a transition plan that reduces dependency, restores client control, and documents the operating model.

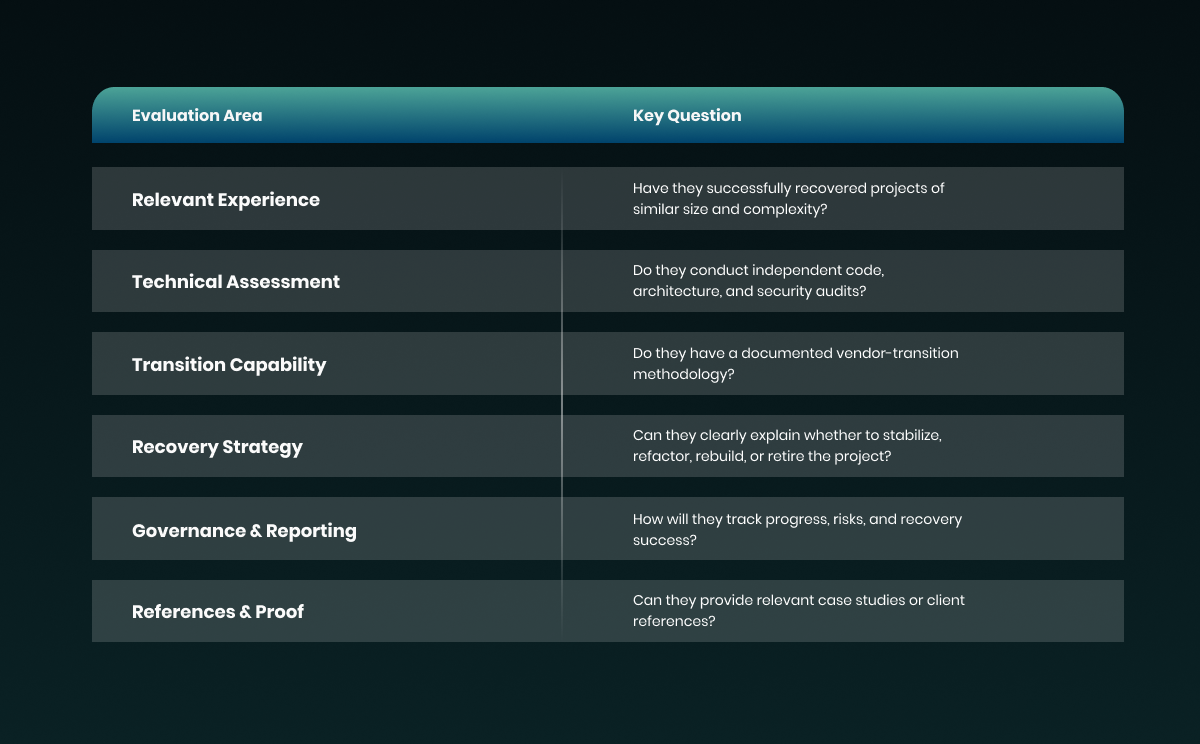

Before investing further, leadership should use a practical software recovery checklist.
Ask whether the business has full repository and infrastructure access, whether the system can be deployed without the old vendor, whether the architecture is documented, whether critical workflows have tests, whether CI/CD works, whether security risks are visible, whether the backlog is clean, and whether there is a 30-day, 60-day, and 90-day recovery roadmap.
This is how businesses save a failing Software development project without blindly funding the same delivery failure.
Recovery partner evaluation checklist:
Unified Infotech combines architecture consulting, custom software development services, QA governance, DevOps maturity, and delivery ownership to stabilize failing projects and turn recovery into predictable product execution.
Custom software project recovery is a control exercise, not a bug-fixing sprint. A 30-day post-mortem helps leadership identify what broke, what can be salvaged, what must be rebuilt, and where vendor or architectural risk must be mitigated.
Unified Infotech helps businesses recover delayed, unstable, or vendor-locked software projects through structured audits, stabilization planning, CI/CD improvement, technical debt assessment, modernization support, and delivery governance.
Need clarity on a troubled project?
And get a practical software project recovery plan built around data, stability, and business outcomes.
Yes, a new software project rescue partner can take over an existing codebase after a structured software project audit, repo access review, dependency mapping, architecture assessment, CI/CD check, and documentation review. The takeover should begin with evidence, not assumptions.
The biggest risks include poor documentation, missing repo access, vendor lock-in, weak test coverage, unclear architecture, hardcoded secrets, unstable deployments, and knowledge gaps. A software development partner audit reduces these risks before the transition begins.
Stabilize first. A failing software project needs release safety, CI/CD baseline, defect control, and risk visibility before major refactoring or rebuilding. Once stable, a technical debt audit can define what to refactor, rebuild, or retire.
Common issues include hardcoded secrets, outdated dependencies, weak authentication, poor access control, exposed APIs, missing SAST and DAST checks, insecure cloud configuration, and weak logging. A software quality assurance audit and DevOps audit should flag these early.
Prevention requires stronger product delivery governance, architecture reviews, CI/CD implementation, test coverage, release ownership, backlog discipline, transparent reporting, and risk management in software development. Recovery should end with better operating discipline, not just a fixed codebase.
